Offshore Wind
  • Fixed-Bottom
  • Floating Wind
  • Supply Chain
  • Contracts & Tenders
  • Grid Connection
  • More news
JobsNewsletter
Offshore Wind logo

Your trusted source for global offshore wind news, part of the Navingo network.

Topics
  • Fixed-Bottom
  • Floating Wind
  • Grid Connection
  • Power-to-X
  • Supply Chain
Network
  • Offshore Wind
  • Dredging Today
  • NavalToday
  • Offshore Energy
  • Maritieme Vacaturebank
Company
  • Advertising
  • Newsletter
  • Jobs
  • Report your news
  • Privacy

© 2026 Navingo. All rights reserved.

Home›News›Last Turbine Up at Kentish Flats Extension
News

August 10, 2015 · about 11 years ago

Last Turbine Up at Kentish Flats Extension

Vattenfall has completed the installation of the final turbine at the Kentish Flats Extension offshore wind farm site. Turbine installation was completed on schedule by GeoSea’s jack up vessel ‘Neptune’ which is now leaving the construction site. “Although a relatively small offshore project, we hav

1 minutes read
  • LinkedIn
  • X
  • Email

Vattenfall has completed the installation of the final turbine at the Kentish Flats Extension offshore wind farm site.

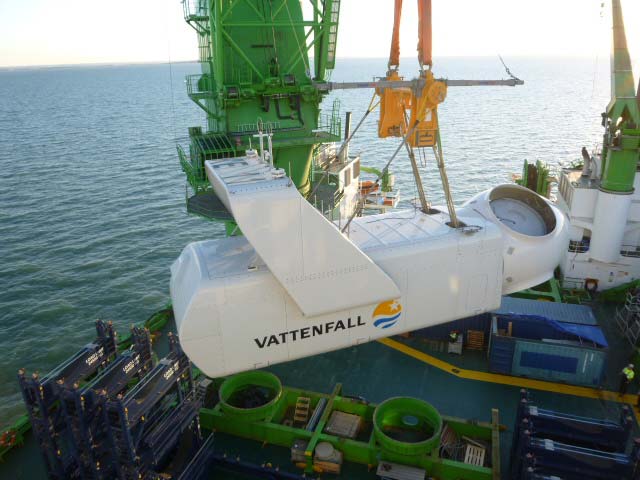

Turbine installation was completed on schedule by GeoSea’s jack up vessel ‘Neptune’ which is now leaving the construction site.

“Although a relatively small offshore project, we have to work within a small window and do not have the luxury of picking up the lost time later as is the case on larger projects. Bringing this part of the project in on time is a real testament to the high level of efficiency across the whole project,” said the company in a statement.

Now that the installation of 15 MHI Vestas V112 3.3MW wind turbines is complete, the project is moving into the commissioning phase. Although a large amount of this work will take place from the turbines, there is also a lot happening at the substation in Herne Bay.

The switchgear power cable terminations have been made ready to be connected to the UKPN network which is scheduled to take place on 18th August. This means that all the high voltage equipment in the wind farm will be considered to be live from this point forward.

Vattenfall expects to be generating electricity by the end of September.

Reach the Offshore Wind industry in one go!

Offshore Wind is read by thousands of professionals every day.

Increase your visibility with banners, tell your story with a branded article, and showcase your expertise with a full-page company profile in our business directory.

CONTACT

Follow Offshore Wind on:

Filed under

News

Daily Offshore Wind News in Your Mailbox

Join thousands of industry professionals who start their day with our newsletter.

Trending Now

  1. 1New Zealand Opens First Offshore Wind Feasibility Permit Round
  2. 2SSE Taps Seaway7 for Berwick Bank B Foundations, Inter-Array Cables
  3. 3Wood Thilsted Secures New Contract on Outer Dowsing Offshore Wind Farm
  4. 4Vattenfall to Offer 200 MW of Balancing Power from German Offshore Wind Farm

Daily Offshore Wind News in Your Mailbox

Join thousands of industry professionals who start their day with our newsletter.

Subscribe free
