Offshore Wind
  • Fixed-Bottom
  • Floating Wind
  • Supply Chain
  • Contracts & Tenders
  • Grid Connection
  • More news
JobsNewsletter
Offshore Wind logo

Your trusted source for global offshore wind news, part of the Navingo network.

Topics
  • Fixed-Bottom
  • Floating Wind
  • Grid Connection
  • Power-to-X
  • Supply Chain
Network
  • Offshore Wind
  • Dredging Today
  • NavalToday
  • Offshore Energy
  • Maritieme Vacaturebank
Company
  • Advertising
  • Newsletter
  • Jobs
  • Report your news
  • Privacy

© 2026 Navingo. All rights reserved.

Home›Vessels›Beatrice Team Readying to Install First Wind Turbines
Vessels

July 2, 2018 · about 8 years ago

Beatrice Team Readying to Install First Wind Turbines

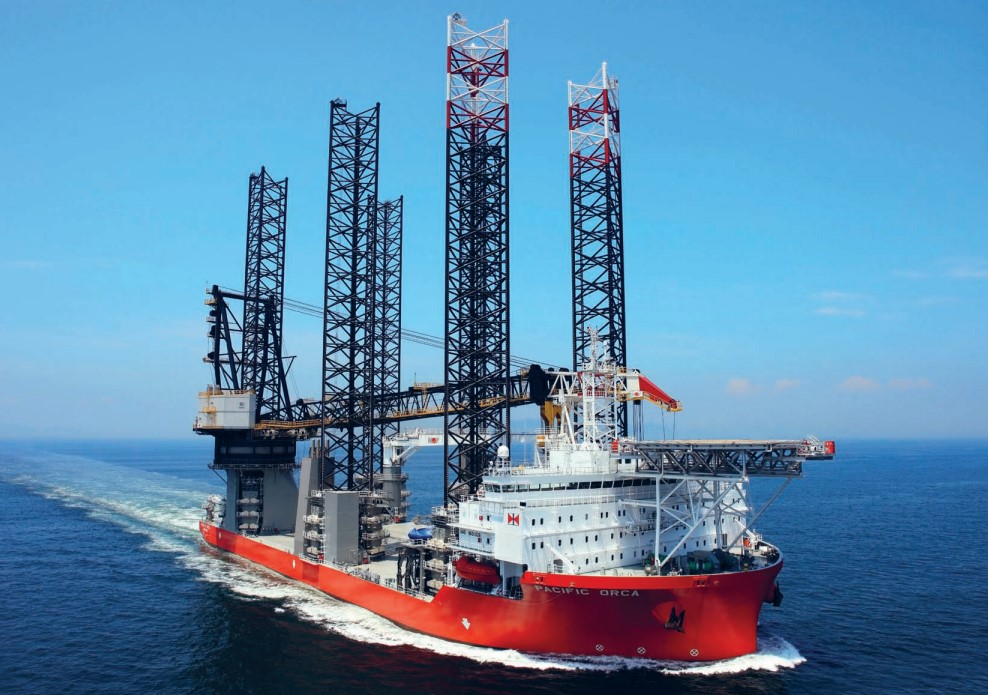

Wind turbine installation vessel Pacific Orca arrived at Nigg Energy Park on 28 June, according to the vessel’s AIS data, as the Beatrice wind turbine installation team is set to start erecting the first Siemens Gamesa 7MW turbines at the project site off Scotland.

1 minutes read
  • LinkedIn
  • X
  • Email

Wind turbine installation vessel Pacific Orca arrived at Nigg Energy Park on 28 June, according to the vessel’s AIS data, as the Beatrice wind turbine installation team is set to start erecting the first Siemens Gamesa 7MW turbines at the project site off Scotland.

The project’s marine coordination team has issued a Notice to Mariners, saying that the wind turbine installation and commissioning works will commence offshore during July 2018, with finalisation of the installation in spring 2019.

Siemens Gamesa is supplying 84 of its SWT -7.0-154 wind turbines, which will be pre-assembled at Nigg Energy Park. In the past several weeks, the turbine tower manufacturer CS Wind shipped towers to Nigg Energy Park in two rounds from its facility on the Kintyre peninsula.

Following pre-assembly, five sets of turbines will be loaded onto the Pacific Orca and transported to the construction site, where they will be installed in a pre-programmed installation sequence.

The commissioning works will be carried out using a combination of the walk-to-work vessel Island Crown and crew transfer vessels (CTV) Fob Swath 3 and Seacat Resolute.

SGRE will also install and commission the Supervisory Control and Data Acquisition (SCADA) system for the operation of the wind turbines.

As reported previously, the Beatrice team expects the first turbines to produce power in July.

Offshore WIND Staff

Reach the Offshore Wind industry in one go!

Offshore Wind is read by thousands of professionals every day.

Increase your visibility with banners, tell your story with a branded article, and showcase your expertise with a full-page company profile in our business directory.

CONTACT

Follow Offshore Wind on:

Filed under

VesselsWind Farm Update

Daily Offshore Wind News in Your Mailbox

Join thousands of industry professionals who start their day with our newsletter.

Trending Now

  1. 1US Wind Gives Up Sparrows Point Site as Offshore Wind Project Faces Delays
  2. 2Dogger Bank B Wind Turbine Installation Passes Halfway Mark
  3. 3GWEC Calls for Government Action to Accelerate Floating Wind Commercialisation
  4. 4France Energies Marines Launches Four Offshore Wind R&D Projects

Daily Offshore Wind News in Your Mailbox

Join thousands of industry professionals who start their day with our newsletter.

Subscribe free
